Project 01 · Industrial production

Bentonite granulate production.

A phased production programme for a granulated soil improver that combines bentonite's water-retention properties with documented organic nutrient inputs.

€1.81mIndicative investment
5 t/hNominal processing line
5,500 t2031 granule output
€4.10m2031 total revenue

Project thesis

Mineral performance. Organic utility. Industrial repeatability.

The product concept brings together selected bentonite, documented animal manure and straw in a stable, packaged granulate. The aim is to support soil water management and nutrient delivery through a repeatable industrial process rather than a one-off formulation.

The initial market focus is professional: specialist horticulture, nurseries, landscaping, professional growers and agricultural distributors serving sandy-soil and water-management needs. Broadacre applications remain a secondary expansion route.

Operating system

What the project is designed to build.

One integrated production and market-development system, planned for Styria, Austria.

01

Controlled feedstock

Selected mineral input and documented organic components received, inspected and prepared against defined process parameters.

02

Stable granulation

A nominal 5-tonne-per-hour line for conditioning, granulation and sizing, with an illustrative annual capacity of 6,160 tonnes at stated operating assumptions.

03

Traceable quality

Batch records, particle-range controls, packaging discipline and product release checks built into the operating flow.

04

Professional channels

B2B market development through distributors, professional growers, horticulture, nurseries and landscaping customers.

Why the model matters now

Turn a difficult material stream into a transportable, measurable product.

Tighter storage, nutrient-management and slurry-spreading requirements increase the operating burden of handling untreated manure and slurry. The proposed route captures that pressure as an industrial opportunity: controlled preparation, thermal processing, granulation and packaging convert a difficult input into a stable commercial format.

The result is easier to store, transport, dose and distribute than untreated slurry, while bentonite adds water-retention and soil-conditioning functionality to the organic nutrient base.

01

Controlled treatment route

Moves material from open-ended storage and field-spreading pressure into a documented, repeatable production flow.

02

Lower handling burden

Granules replace high-water-volume transport with a denser, baggable product designed for predictable logistics and dosing.

03

Longer commercial reach

A stable 3–6 mm product can move through distributors, nurseries, horticulture and professional growing channels beyond the immediate farm radius.

04

More precise application

Consistent particle size and batch data support controlled use instead of variable, weather-dependent slurry spreading.

Existing supply relationship

Ukrainian bentonite with an established commercial route.

The project has an existing commission/consignment raw-material agreement and a strong working relationship with a Ukrainian bentonite mine in the Vinnytsia region, operating outside the active war zone. The commercial model combines this established source with planned buffer stock and alternative European supply options to support continuity as production scales.

Production logic

Eight connected stages from intake to saleable granulate.

The line is designed around controlled material flow, thermal treatment, repeatable particle size and batch-level release.

  1. 01

    Intake and batch identification

    Receive bentonite, documented animal-manure inputs and straw; record origin, weight, moisture and the batch identity before unloading.

  2. 02

    Protected storage and dosing

    Keep mineral and organic inputs separated under controlled storage, then meter each component to the approved formulation.

  3. 03

    Pre-processing and homogenisation

    Reduce oversized material, blend the feed and stabilise moisture so the dryer and granulator receive a consistent stream.

  4. 04

    Drying and thermal treatment

    Remove excess water under monitored temperature and residence-time settings, with enclosed air, dust and odour-management systems.

  5. 05

    Granulation

    Compress and form the conditioned blend through the nominal 5 t/h line into round granules designed for a 3–6 mm product range.

  6. 06

    Cooling, screening and return loop

    Cool the product, separate the target fraction and return off-size material to the process rather than losing usable feedstock.

  7. 07

    Quality release and packaging

    Check moisture, particle range, mechanical stability and batch records before bagging, palletising and assigning product identification.

  8. 08

    Warehouse and B2B dispatch

    Move released stock into finished-goods storage and serve distributors, horticulture, nurseries, landscaping and professional growers.

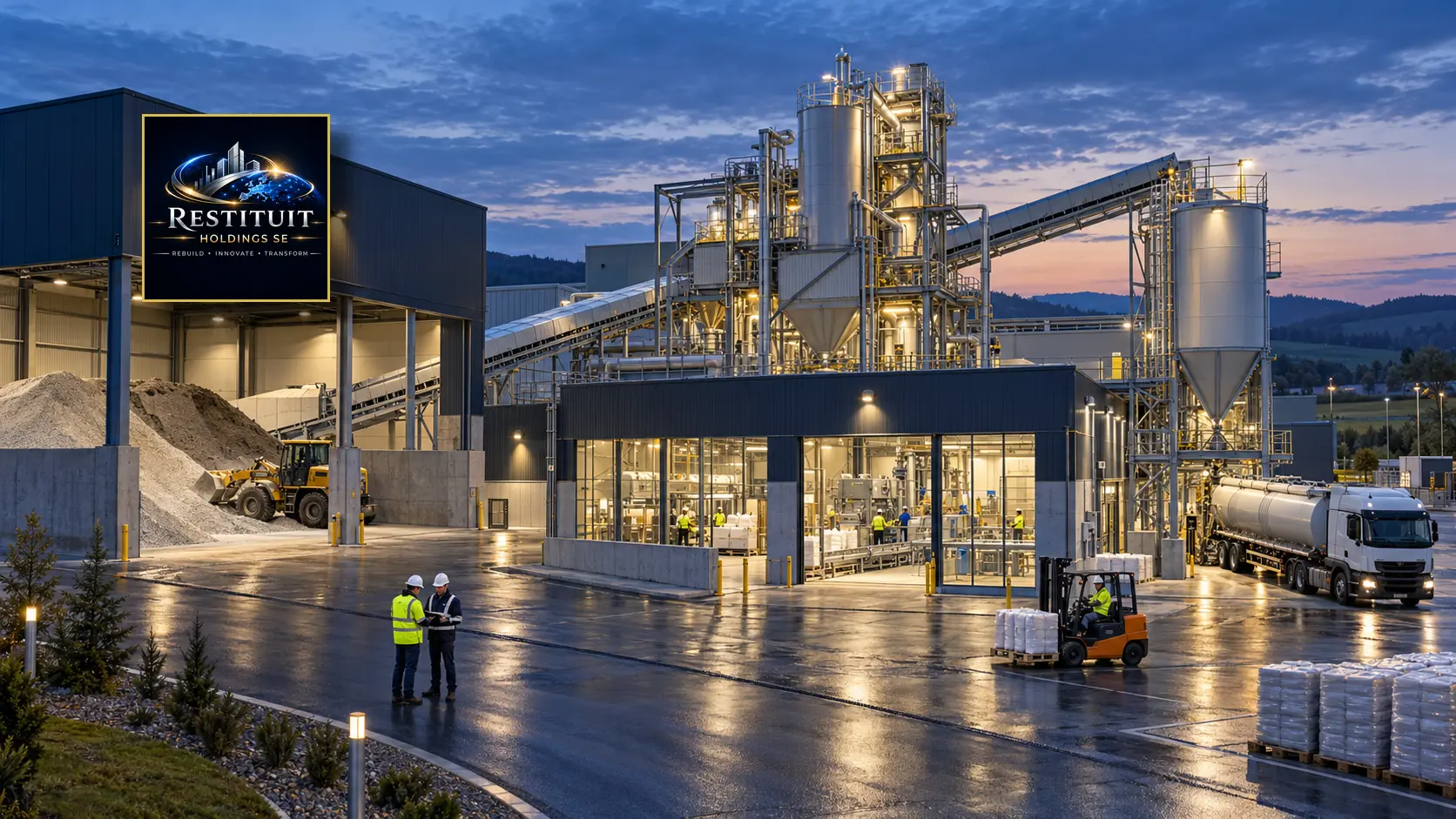

Photorealistic concept of the planned RESTITUIT bentonite granulate production facility
Photorealistic design visual · planned medium-scale 5 t/h production campus

The completed plant

A compact industrial campus built around clean material flow.

The concept separates raw-material receiving, covered mineral storage, drying and granulation, screening, bagging, finished-goods warehousing and truck dispatch. Enclosed conveyors and local extraction keep the process legible and controllable, while glazed operating areas make supervision and quality checks part of the visible workflow.

  • Covered bentonite and organic-input receiving
  • Enclosed drying, granulation and screening line
  • Dedicated quality-control and batch-release area
  • Automated bagging, palletising and loading bays
  • Space for buffer stock and phased capacity growth

From raw slurry to managed product

Why granulation improves the operating equation.

Conventional direct use

High water, narrow radius, variable timing.

  • Large transport volume relative to nutrient content
  • Storage and spreading tied to weather and field-access windows
  • Variable moisture and nutrient concentration
  • Greater exposure to odour, runoff and handling losses
RESTITUIT production route

Stable format, documented batch, broader market.

  • Reduced water burden and more efficient transport
  • Metered 3–6 mm granules suitable for packaging and distribution
  • Bentonite plus organic inputs in one repeatable product
  • Year-round inventory planning and controlled commercial dispatch

Investment architecture

€1.81m directed into production readiness.

The investment structure separates physical line capability, site fit-out, safety and environmental systems, packaging, integration and project contingency.

Indicative investment breakdown
Leased-site fit-out€300,000
Production line€500,000
Hygiene + environmental systems€180,000
Bagging system€130,000
Warehouse + forklift€90,000
Electrical, laboratory + safety€50,000
Engineering, integration + installation€150,000
Contingency€210,000
Licence provision€200,000
Total investment€1,810,000

Sources + uses

Investment
€1.81m
Pre-opening expense
€90k
Opening cash reserve
€650k
Total drawn funding
€2.55m
Cash equity
€1.40m
Term loan
€1.15m
Committed revolving line
€250k
Total commitments
€2.80m

2028–2031 planning model

Revenue, margin and profit progression.

The model combines granule sales and planned raw-bentonite resale. Figures below reproduce the supplied four-year planning case.

Detailed four-year economics
Metric2028202920302031
Granule output2,000 t3,500 t4,500 t5,500 t
Raw bentonite resale400 t600 t800 t1,000 t
Total revenue€1,420,000€2,488,800€3,277,260€4,096,263
EBITDA−€46,680€262,451€485,000€706,287
EBITDA margin−3.3%10.5%14.8%17.2%
Net result−€328,180−€16,937€163,775€340,359
EBITDA break-even volume2,175 t2,522 t2,705 t2,903 t
2030First positive annual net result

€163,775 in the supplied planning model.

203117.2% EBITDA margin

€706,287 EBITDA on €4.096m total revenue.

14 FTEPlanned year-four team

Staffing rises from 10 FTE in 2028 as output scales.

18-month implementation

Stage decisions before capital intensity.

Each phase produces a practical decision point before the next level of commitment.

  1. Months 1–3

    Rights, site + regulatory scoping

    Confirm project rights, location fit and the pathway for technical and operating requirements.

  2. Months 2–6

    Pilot, trials + financing

    Develop product trials, commercial feedback and the financing package in parallel.

  3. Months 4–9

    Permits + procurement

    Complete final technical definition and place key equipment and integration packages.

  4. Months 7–14

    Construction + installation

    Prepare the leased site, install the line, packaging, safety and supporting systems.

  5. Months 13–18

    Commissioning + ramp-up

    Commission, qualify output and move from controlled batches to repeatable commercial operation.

Project conversation

Discuss production, supply or market cooperation.

TPME Trade s.r.o. is the project sponsor for the supplied planning case.
